11BIO home

  • Continuous operation

    About 7,200 operating hours a year.


  • Self-powered

    Runs on its own syngas and recovered heat.


  • Built to replicate

    One standard 25-ton-per-day plant design.

How a plant works

Biomass goes in, biochar comes out, and the process powers itself.

How an 11BIO plant worksFlow diagram. Feedstock intake leads to drying, then to the pyrolysis reactor, which produces biochar. Syngas from the reactor goes to heat and power recovery, which sends heat back to drying and supplies plant electricity and surplus for local farms.Feedstock intakeDryingPyrolysis reactorBiocharSyngasHeat and power recoveryHeatPlant electricity and surplusfor local farms

Integrated emissions controls and heat recovery keep the plant efficient and within environmental and regulatory requirements.

Built for continuous operation

Proven biochar production technology

Our facilities use established industrial pyrolysis machines that convert waste biomass into biochar through a controlled, low-oxygen heating process. These systems are commercially proven, designed for continuous operation and capable of delivering consistent biochar quality.

A cost-efficient equipment strategy

We source high-quality, widely deployed production systems from experienced manufacturers. That keeps upfront investment low while maintaining operational performance, scalability and long-term reliability.

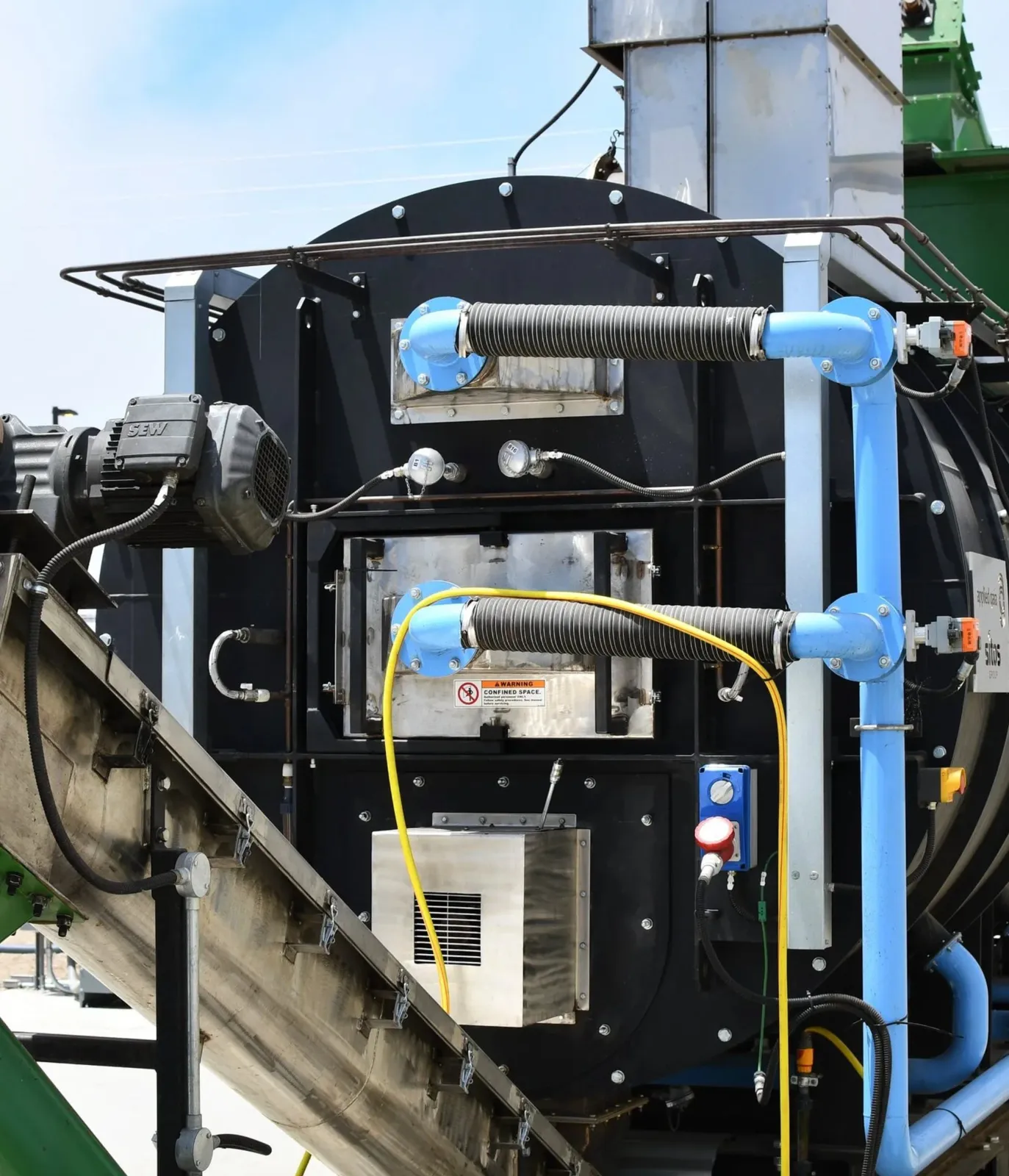

Pyrolysis unit with insulated heat-recovery pipework

Energy self-sufficient by design

Our plants use syngas and recovered waste heat from pyrolysis to power all of their own electricity and heat needs, including plant operations, material handling and feedstock drying. Depending on the system design, a plant is expected to generate surplus electricity.

We share that surplus with nearby farms and local partners in exchange for access to low-cost land and a reliable supply of waste biomass, where it can run irrigation, cold storage and processing equipment. The result is lower operating costs, more secure feedstock and lasting community partnerships.

  • Irrigation

    Surplus power for irrigation systems on nearby farms.


  • Cold storage

    Surplus power for local cold storage.


  • Processing

    Surplus power for local processing equipment.

From site to first credits in 10–12 months

The build timeline for a standard 25-ton-per-day plant.

  1. 2 months

    Site selection and permitting

    We identify a suitable site, secure land access and confirm long-term biomass supply agreements. Environmental reviews and permitting are completed, and we engage carbon certification bodies early so the project design meets verification requirements.

  2. 5–6 months

    Engineering, procurement and construction

    Detailed engineering is finalized while the production equipment is manufactured, shipped and delivered. Site preparation, civil works and installation of the pyrolysis system, emissions controls, power generation and utilities happen in parallel.

  3. 1 month

    Commissioning and first operations

    All systems are tested, calibrated and optimized for stable, continuous operation. Staff training and safety procedures are completed, biochar production begins, and monitoring systems start collecting the data needed for certification.

  4. 2–3 months

    Certification and revenue

    Third-party auditors review operational data under the selected carbon standard. Once verified, credits are issued and registered, and sales begin through pre-arranged offtake agreements and carbon marketplaces.

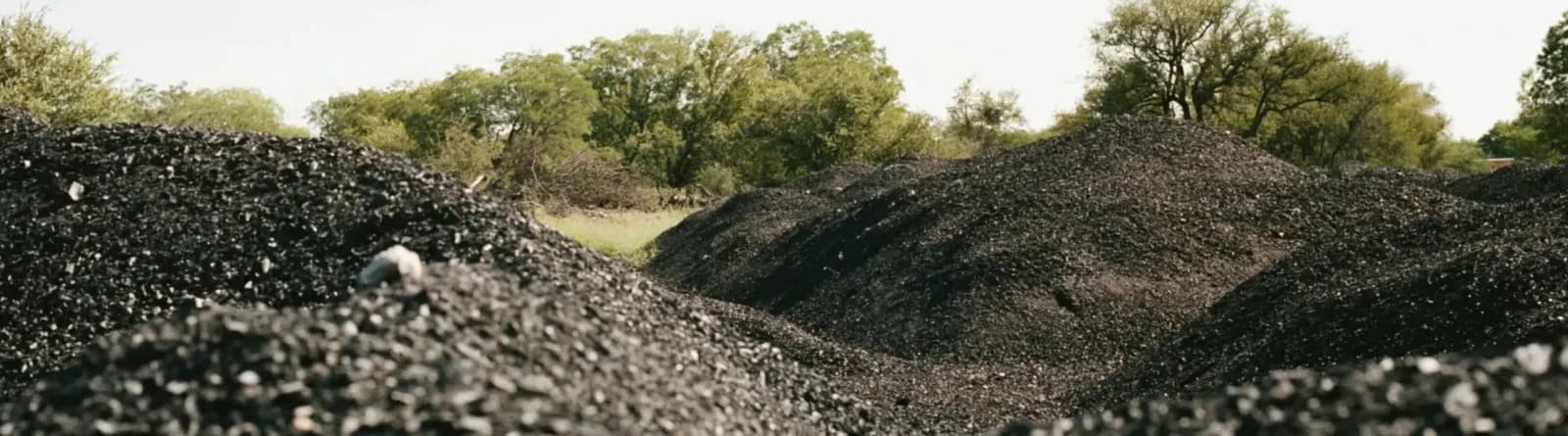

Large stockpiles of biochar in an open field

Built to scale

Replicating a proven plant

Our standard 25-ton-per-day plant produces about 1,600–1,800 tons of biochar and 3,700–4,900 carbon credits a year, depending on certification factors. Once validated, the same configuration can be replicated wherever biomass is abundant, giving predictable performance, consistent credit quality and controlled operational risk.

Larger plants and new markets

After replication, we can expand through larger 40–60-ton-per-day facilities or clustered multi-unit sites. A 50-ton-per-day facility could produce about 3,200–3,600 tons of biochar and 7,500–10,000 carbon credits a year. Scaling into high-demand regions improves economies of scale and strengthens long-term offtake relationships.

Planning a biochar project?

Whether you have feedstock, land or a site in mind, we would like to hear about it.

Get in touch
